SBA 7(a) Tenant Enhancements for Leased House: What You’ll Want

-


A leased area can appear to be the precise location, however it might take weeks and even months earlier than it’s able to open. Important work like plumbing, electrical, HVAC, flooring, restrooms, and different permitted work usually must be accomplished earlier than the enterprise can begin working.

CDC Small Enterprise Finance, a part of the Momentus Capital branded household of organizations, can finance tenant enhancements (TI) by way of the SBA 7(a) Group Benefit mortgage program. The important thing query isn’t simply whether or not the build-out will be funded, but additionally what must be in place early on to make sure the undertaking transitions easily from prequalification to closing and attracts with out pointless delays.

Most delays in tenant enhancements for leased areas usually come up from just a few frequent points: misalignment of lease phrases, incomplete contractor bids, timing of permits, and misunderstandings concerning attracts and landlord reimbursements. Whereas these issues should not unusual, addressing these points early, earlier than signing the ultimate lease and beginning development, tends to forestall the commonest delays in underwriting, closing, and fund management.

What Counts as Tenant Enhancements (and Why it Issues for Financing)

With regards to financing leased areas, tenant enhancements (additionally referred to as leasehold enhancements) are the modifications required to make the area usable for a enterprise. These enhancements normally embody numerous build-out components corresponding to home windows, flooring, plumbing, HVAC, electrical work, and comparable work that requires a contractor or permits. Portray will be included within the TI funds, even when among the work is finished independently.

Banks and lenders deal with these things as greater than development line objects as a result of TI initiatives are tied to permits, inspections, opening timelines, and contractor documentation. For companies that depend on particular places, particularly customer-facing companies, the positioning is a part of the compensation image, so the lease and build-out plan are underwriting points from day one.

For debtors contemplating an owner-occupied property, try our SBA 504 tenant enhancements weblog.

The “Don’t-Signal-But” Timeline (What Can Occur Earlier than the Lease is Closing)

Many debtors assume they must signal the ultimate lease earlier than they will speak to a lender. That assumption can create leverage issues and out-of-pocket threat. We suggest beginning finance discussions whereas working from a draft Letter of Intent (LOI) or draft lease, so long as a walkthrough-based estimate from a contractor who has truly seen the area is supplied.

As soon as a mortgage officer has taken a take a look at the paperwork, they will present a pre-prequalification letter. This letter serves as a written indication that, primarily based on a fast overview of the LOI, undertaking scope, and TI estimate, the undertaking appears to satisfy the preliminary financing standards. Whereas this generally is a useful instrument throughout lease negotiations, it’s necessary to do not forget that it doesn’t equate to a mortgage approval dedication and doesn’t assure the ultimate phrases or funding.

When the Venture is “Actual Sufficient” to Evaluation

In apply, the deal can begin shifting as soon as two issues present up:

  1. A draft LOI or draft lease
  2. A TI estimate from a contractor who has walked the area

This estimate doesn’t must be a finalized development contract on the prequalification stage. As a substitute, a tough estimate can suffice if the drawings aren’t but full. Underwriting could take a look at the higher finish of the estimate to cut back the danger of underfunding the undertaking. If later drawings push the price meaningfully larger, the construction could have to be adjusted.

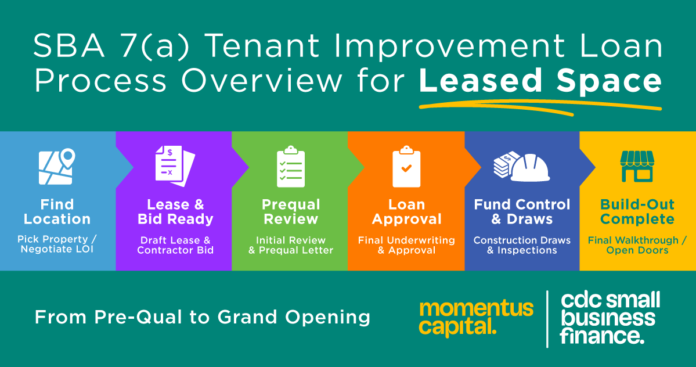

TSBA 7(a) tenant improvement loan process overview graphic with construction draws and fund control.
That is the everyday sequence CDC Small Enterprise Finance sees for leased-space tenant enchancment initiatives. Debtors can usually keep away from delays by lining up the LOI/draft lease and walkthrough-based TI estimate early.

Lease Time period Necessities & Landlord Paperwork That Can Stall a Deal

Lease time period alignment is commonly one of many first hurdles that may decelerate a TI deal, and it tends to be underestimated. Many individuals mistakenly imagine that the borrower has to decide to staying within the area for the complete mortgage time period. The actual query is whether or not the borrower has the authorized proper to occupy the area lengthy sufficient to cowl compensation, which incorporates any relevant renewal choices.

That’s why having a five-year lease with renewal choices will be simply as necessary as an extended preliminary time period. With regards to underwriting, the main target is on occupancy rights reasonably than simply present intentions. CDC Small Enterprise Finance’s Director of Credit score Underwriting Nick Miluso notes that lease time period alignment is about confirming that “occupancy rights assist compensation, particularly for companies whose income will depend on that particular location.”

Landlord-related paperwork may also delay a TI mortgage, particularly when landlords have to be concerned within the reimbursement course of. Issues like landlord waivers and assignment-of-lease can create friction, and bigger purchasing facilities usually face delays due to the intricate property administration and authorized approvals which are wanted for the required paperwork.

One necessary lease time period that may considerably influence a enterprise’s runway is hire abatement. For the reason that allowing and development processes can stretch on for months, it’s sensible for debtors to barter hire abatement early on. This fashion, hire received’t kick in till the enterprise is able to open its doorways and has an influx of money.

Fund Management & Building Attracts Defined (Why Contractors Do Not Get Deposits)

In leased-space TI initiatives, debtors usually count on a single development test after closing. That isn’t how the disbursement course of normally works. Fund management and attracts are usually a staged reimbursement course of: fee is launched for verified work accomplished, not future work.

Right here’s a easy breakdown of how fund management and development draw sequences work:

  • The work is split into phases, like demo, electrical, framing, and finishes.
  • The contractor sends in a draw request together with invoices and lien waivers.
  • An inspection or verification step confirms that the work is on observe.
  • As soon as every thing checks out, the lender approves the draw.
  • The funds are launched to the contractor, both through test or ACH, which normally takes about 5 to seven enterprise days.

Nick Miluso factors out that fund management shouldn’t be solely a lender safeguard; it’s additionally a means to make sure every thing is on observe and to collect lien documentation. “Fund management is a safety, not a hurdle,” he says. “It’s simply as a lot a borrower safety as a lender safety. It reduces the danger of any unresolved development points coming to mild when the enterprise is making an attempt to open.”

With regards to sensible points, we frequently discover that the friction factors are extra about operations than concept. Some typical examples embrace:

  • Lacking lien waivers
  • Incomplete invoices
  • Unapproved change orders
  • Draw requests submitted earlier than the work is completed

How the contractor relationship is structured has a direct influence on how easily the draw course of goes. Listed here are the important thing issues to bear in mind:

  • Use one common contractor (GC) or prime contractor for the complete build-out.
  • Keep away from treating the undertaking like an owner-builder job with a number of separate funds to completely different subcontractors.
  • Be ready for fund management to ask for contractor licensing and insurance coverage paperwork.
  • Make certain to have a fixed-price development contract (not a shifting quote/time-and-materials method) for managing development attracts.

One of many largest causes for delays is the allowing course of, which may result in money move points when lease funds and pre-opening prices begin piling up earlier than the development funds can be found.

A group of people joyfully cutting a ribbon to celebrate the grand opening of a beauty supply store.
SBA 7(a) tenant enhancements are funded by way of development attracts through the build-out. Nonetheless, if tenant enchancment allowance (TIA) reimbursements are included within the lease, they usually present up after completion and have to be deliberate for from the beginning.

Tenant Enchancment Allowance (TIA) — A Actual Profit, however Plan for Reimbursement Guidelines

A tenant enchancment allowance (TIA) is a monetary contribution from the owner to assist with the renovations of a rented area. Nonetheless, debtors usually suppose it covers greater than it truly does and are left ready longer than anticipated for the funds. A TIA received’t cowl the complete funds for the build-out, and the reimbursement occurs solely after the work is finished. There could be a necessity for inspections and lien waivers earlier than the cash is launched. Moreover, comfortable prices corresponding to permits, design, engineering, and a few metropolis charges usually fall outdoors the contractor’s quote and aren’t a part of what the owner will cowl.

A TIA reimbursement is greater than only a lease profit; it additionally ties into how loans are structured. When the funds from an SBA 7(a) mortgage are used to cowl enhancements, and the owner later reimburses these bills, there’s usually a selected strategy to handle that reimbursement. Usually, it includes paying down the principal, until the lender has documented a unique method that meets SBA pointers.

Leased-House TI Readiness Guidelines

The quickest TI offers are likely to occur when the borrower has a transparent understanding of the scope, timeline, and funds. This implies working with one common contractor, having a sensible scope of labor (together with a contingency plan), and treating permits as key elements within the timeline.

  • Draft Letter of Intent (LOI) or lease that clearly outlines any renewal choices
  • Walkthrough-based estimate from a common contractor or prime for the complete undertaking
  • Funds that features comfortable prices, not solely the contractor quote (permits, design/engineering, utility/metropolis charges, deposits as relevant)
  • Contingency constructed into the TI funds (usually 10 %)
  • Allow timing handled as an necessary scheduling issue
  • TIA language recognized and flagged for underwriting overview, if relevant
  • No demo or development began earlier than lender approval, closing, and all required paperwork in place

Leased-space TI financing is manageable, however the sequence drives the timeline. Debtors who convey a draft LOI or lease, a walkthrough-based TI estimate, and a sensible funds into the method early give underwriting and fund management a cleaner path.

FAQ

Sure. SBA 7(a) Group Benefit can finance tenant enhancements for leased-space build-outs, so long as every thing meets the required underwriting, documentation, and undertaking management necessities.

Does a borrower have to signal the lease earlier than making use of for an SBA mortgage?

No, the ultimate executed lease shouldn’t be required earlier than approval. The mortgage course of can proceed with only a draft Letter of Intent (LOI) or a draft lease, together with a TI estimate primarily based on a walkthrough.

What’s fund management and why are attracts used?

Fund management is a third-party-managed disbursement course of used to launch TI funds in levels after accomplished work is verified. Attracts assist doc progress, assist inspections, and accumulate lien waivers/releases.

Why received’t the contractor get a deposit upfront?

In our fund-controlled TI loans, funds are launched by way of attracts after verified work. So, contractors usually don’t obtain conventional upfront deposits. Contractors ought to perceive this earlier than the undertaking begins.

What’s a tenant enchancment allowance (TIA)?

A TIA is a landlord contribution towards enhancements in leased area. It’s usually tied to everlasting enhancements and should not cowl comfortable prices, permits, FF&E (furnishings, fixtures, and tools), signage, or working capital. It is usually reimbursed after work is full, not paid upfront.

If the owner reimburses TI prices, what occurs to that cash?

In lots of circumstances, the reimbursement is utilized to the SBA mortgage (principal paydown), until the lender has documented an allowed various use underneath SBA necessities, corresponding to supported working capital wants. The important thing takeaway is to flag the TI allowance early so the lender can construction it accurately earlier than closing.

What causes delays in leased-space TI financing?

The commonest delays are allow delays, incomplete draw paperwork, unapproved change orders, funds gaps (particularly lacking comfortable prices/contingency), and contractor/setup points corresponding to a number of contractors as an alternative of 1 GC or prime contractor.

This submit is for common instructional info and isn’t authorized recommendation. Debtors ought to seek the advice of certified authorized counsel on lease phrases, landlord agreements, and authorized obligations.

Related articles

LEAVE A REPLY

Please enter your comment!
Please enter your name here

Stay Connected

0FansLike
0FollowersFollow
0FollowersFollow
0SubscribersSubscribe

Latest posts
